Building Pad Preparation in NC: The Fill-Compaction-Proof-Roll Sequence Explained

NC building pad compaction operator finishing clay fill lift.

How is a building pad prepared in NC?

What are the three phases of building pad preparation in NC?

Fill placement in lifts (typically 6-8 inch layers), compaction to spec -- 95% standard Proctor on most residential pads -- and proof-roll testing: a loaded roller or truck driven over the surface to find soft spots. In NC clay, if the fill goes down wet, the pad will not hold. Ask for the compaction test report before the concrete pours.

Why does NC red clay make pad prep harder than other states?

Piedmont clay has a narrow moisture window for compaction to work. Too wet and the roller just pumps the material -- it looks compacted but bearing capacity is not there. Too dry and the clay does not bind. Experienced crews time lifts around the forecast and test moisture content before each pass.


The concrete pour is scheduled for Tuesday. The grading crew was on site last week. The pad looks flat. But “looks flat” and “is correctly prepared” are not the same thing — and once the concrete cures, the difference is invisible.

North Carolina’s Piedmont clay makes this worse than most states. A pad built on wet fill can look perfect at pour time and fail years later when the footing settles. This page maps what pad preparation actually involves, what the test methods are, and what you can ask for before the concrete truck arrives.

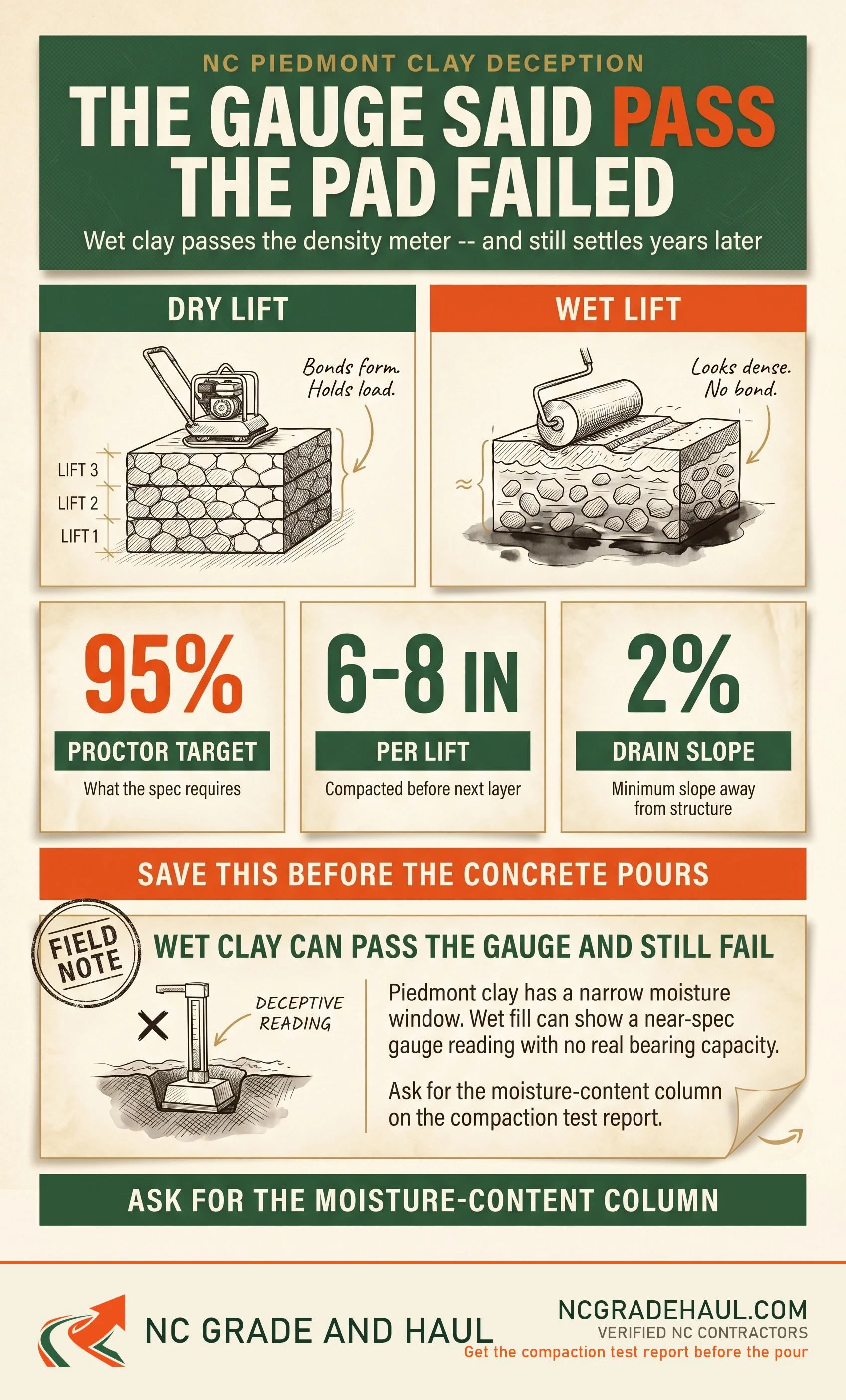

How do you prepare a building pad in NC - NC Grade and Haul infographic.
The whole guide on one card — save it, download the PDF, or pin it.

Fill Placement in Lifts

Fill does not go down all at once. It goes in layers — typically 6 to 8 inches at a time — and each layer gets compacted before the next one goes down.

The lift thickness matters because compaction equipment only densifies material to a limited depth. A roller or plate compactor working on 18 inches of loose fill compacts the top few inches and leaves the bottom loose. Those loose lower inches become the soft zone that causes settlement later.

Standard practice in North Carolina for residential pads: 6-8 inch loose lifts, compacted before the next lift. For deeper fills — common on sloped lots in the Piedmont — the number of lifts stacks up fast. A 3-foot fill requires four or five lift-and-compact cycles, not one pass.

In NC red clay, the moisture content of each lift determines whether compaction actually works. Wet clay placed in lifts will not reach the required density no matter how many passes the roller makes.


A pad built on dry lifts vs one built on wet clay

Comparison. Built on dry lifts: Each 6-8 inch lift placed at optimal moisture; Uniform lifts compacted and density-tested point by point; Proof-roll surface holds with no rutting; Pad slopes for positive drainage away from the structure. Built on wet clay: Wet lift placed over a saturated subgrade; Roller pumps the material -- looks dense, isn't; Soft zone left at the footing perimeter where load concentrates; Pad settles years later, after the concrete has cured.

Built on dry lifts
  • Each 6-8 inch lift placed at optimal moisture
  • Uniform lifts compacted and density-tested point by point
  • Proof-roll surface holds with no rutting
  • Pad slopes for positive drainage away from the structure
Built on wet clay
  • Wet lift placed over a saturated subgrade
  • Roller pumps the material -- looks dense, isn't
  • Soft zone left at the footing perimeter where load concentrates
  • Pad settles years later, after the concrete has cured

Piedmont clay has a narrow compaction window -- wet clay can pass a density gauge and still lack bearing capacity. Ask for the moisture-content column on the test report.

NC Grade and Haul ncgradehaul.com

Compaction to Specification

The target for most North Carolina residential pads is 95% standard Proctor — a density specification, not a visual standard.

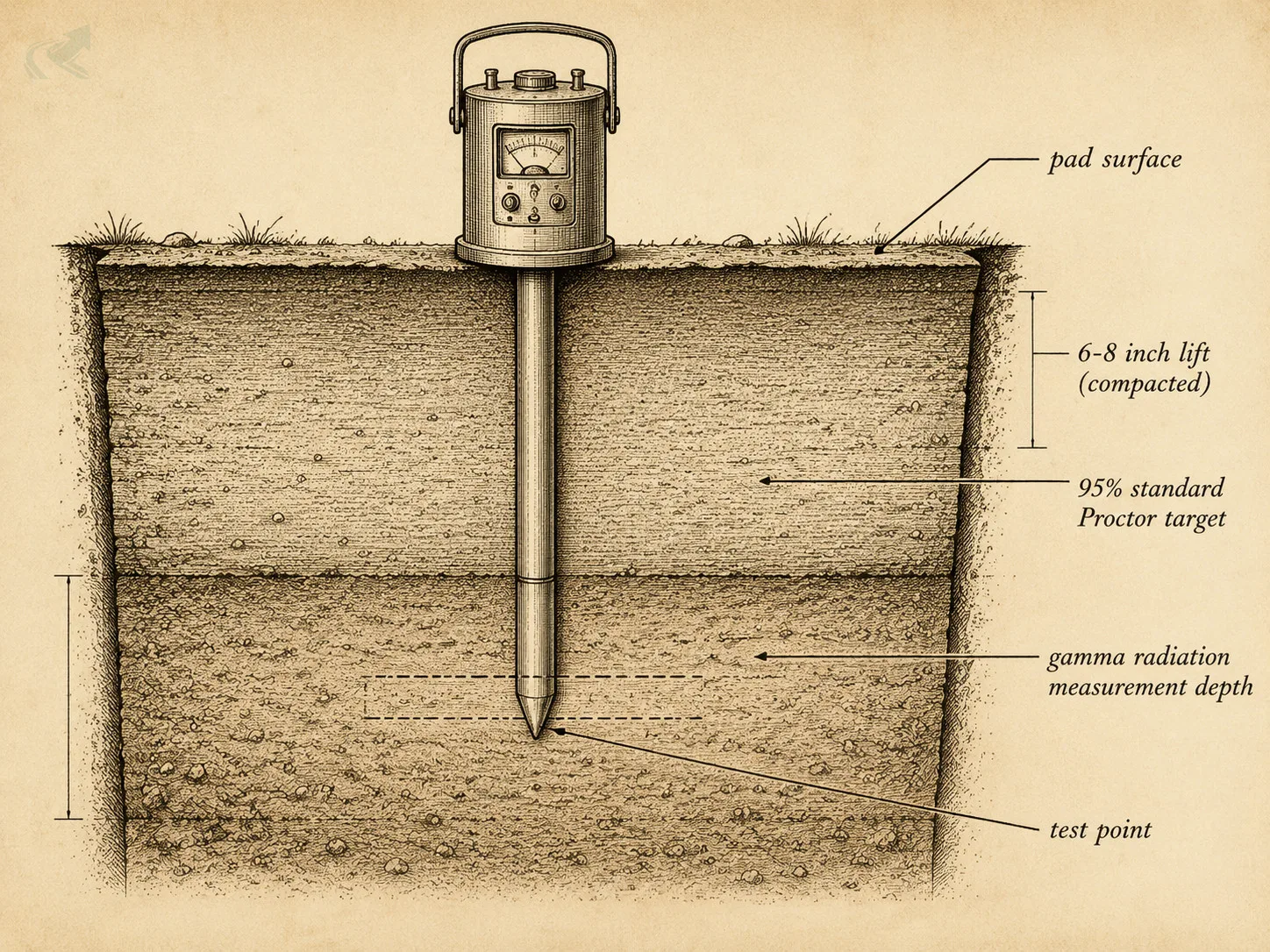

Vintage field-guide cross-section diagram showing a nuclear density gauge probe inserted into compacted clay fill lifts, with leader lines labeling test point, 6-8 inch lift depth, and 95% standard Proctor target.
A nuclear density gauge reads compaction at each test point — the report must show both the percentage (95%+) and the moisture content column for every location on the pad.

defines the benchmark. A testing lab takes a sample of the fill material, compresses it under controlled conditions at multiple moisture levels, and produces a density-moisture curve. The peak of that curve is 100% standard Proctor. Field compaction targets 95% of that number.

In practice, a geotechnical technician drives to the site with a nuclear density gauge — a device that measures in-place density by emitting gamma radiation into the soil and measuring backscatter. The technician records the result at each test point and produces a compaction test report.

That report matters. It lists:

If your builder cannot produce the compaction test report, you do not know whether the pad was actually compacted to spec. You know it looked flat when the crew left.

Copy this and send it to your builder:

“Can you provide the compaction test report for the pad? I need the test point locations, the compaction percentage at each point, and the tester’s name and credentials.”


Proof-Roll Testing

Proof-rolling is a loaded vehicle — typically a heavily loaded dump truck or roller — driven slowly over the prepared pad surface to identify soft spots that passed the density gauge but still have inadequate bearing capacity.

The logic: a nuclear density gauge takes spot readings at specific test points. Proof-rolling is a full-surface check. If any zone of the pad pumps or ruts when the loaded truck drives over it, that zone is soft — regardless of what the gauge said nearby.

In commercial construction in North Carolina, proof-rolling is standard before any concrete placement. On residential pads, it depends on the project. Custom home builders with a geotechnical engineer of record typically require it. Production builders on sites with good native subgrade may skip it and rely on density testing alone.

Whether proof-rolling happened is worth asking before the pour. If it was required by the project’s geotechnical report and the crew skipped it, that is a documentation gap — and a builder accountability question that your NC builder accountability checklist covers in detail.

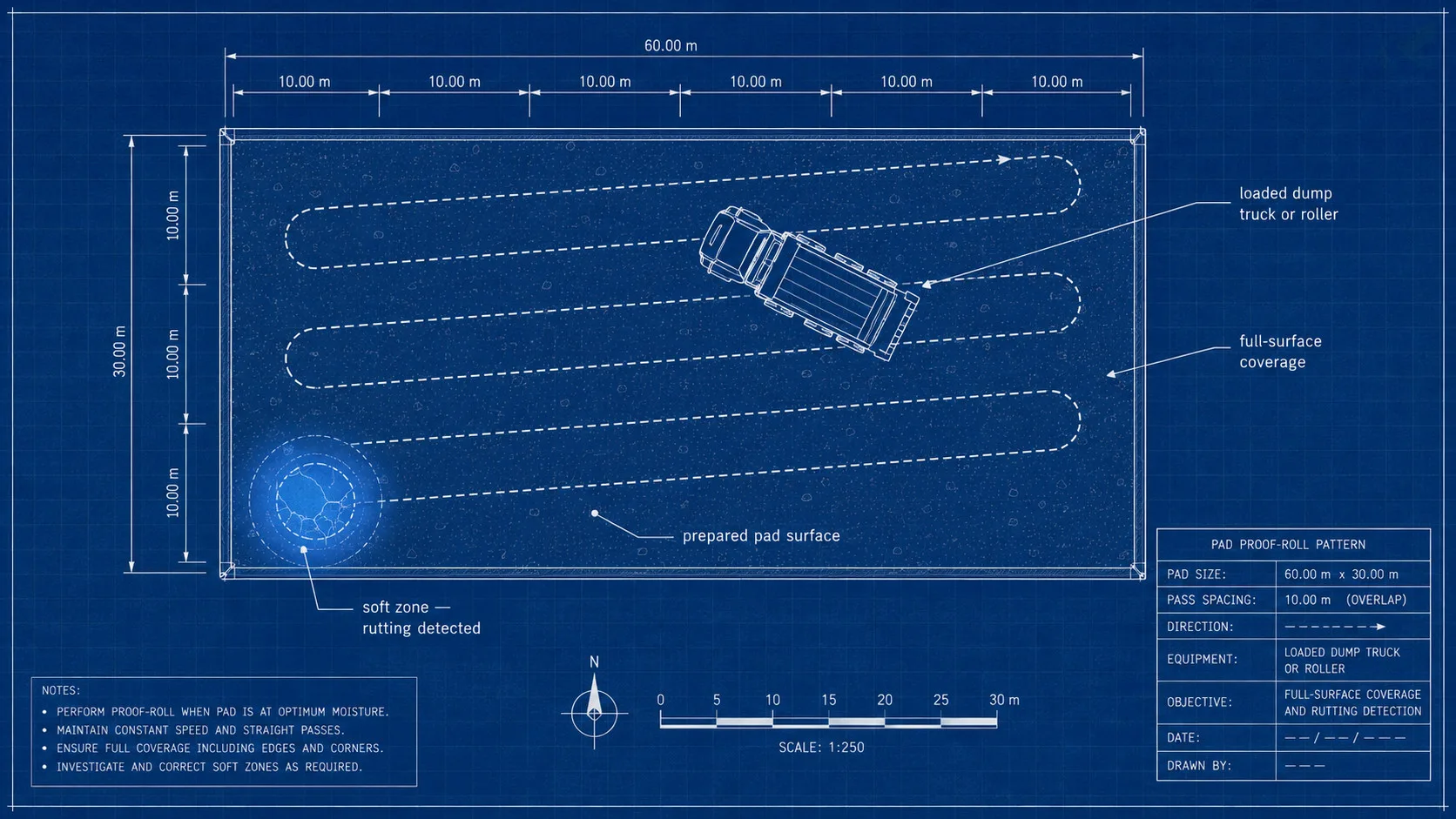

Blueprint top-down diagram of a building pad proof-roll coverage pattern, showing a loaded dump truck path in overlapping lanes and a highlighted soft-zone detection area in one corner.
Proof-rolling is a full-surface check — the loaded vehicle drives overlapping lanes so no zone escapes the load test. A soft zone pumps or ruts under the truck even if the nearby density gauge reading passed.

NC Clay Moisture Management

Piedmont clay has a compaction window. Hit it and the pad reaches spec in a few passes. Miss it — wet or dry — and more roller passes do not fix it.

North Carolina’s red clay behaves differently from sandy fill material. Clay particles bond when moisture is at the right level — not too low, not too high. Standard Proctor testing defines that optimal moisture content for each specific soil. Field crews test moisture on site before each lift goes down.

The wet side of the curve is where most NC pad failures happen. A clay lift placed wet — either because recent rain soaked the subgrade, or because the delivered fill was too wet — can roll out smooth, hold a density gauge reading that looks close, and still have inadequate bearing capacity. The clay particles are not properly bonded; they are floating in water. When the water eventually drains and the clay consolidates, the pad settles.

Signs a crew is managing moisture correctly:

Signs they may not be:

For more on using NC red clay as pad fill — when it is appropriate structural fill and when screened, spec’d fill is a better choice — the fill dirt hauling section covers that in detail.

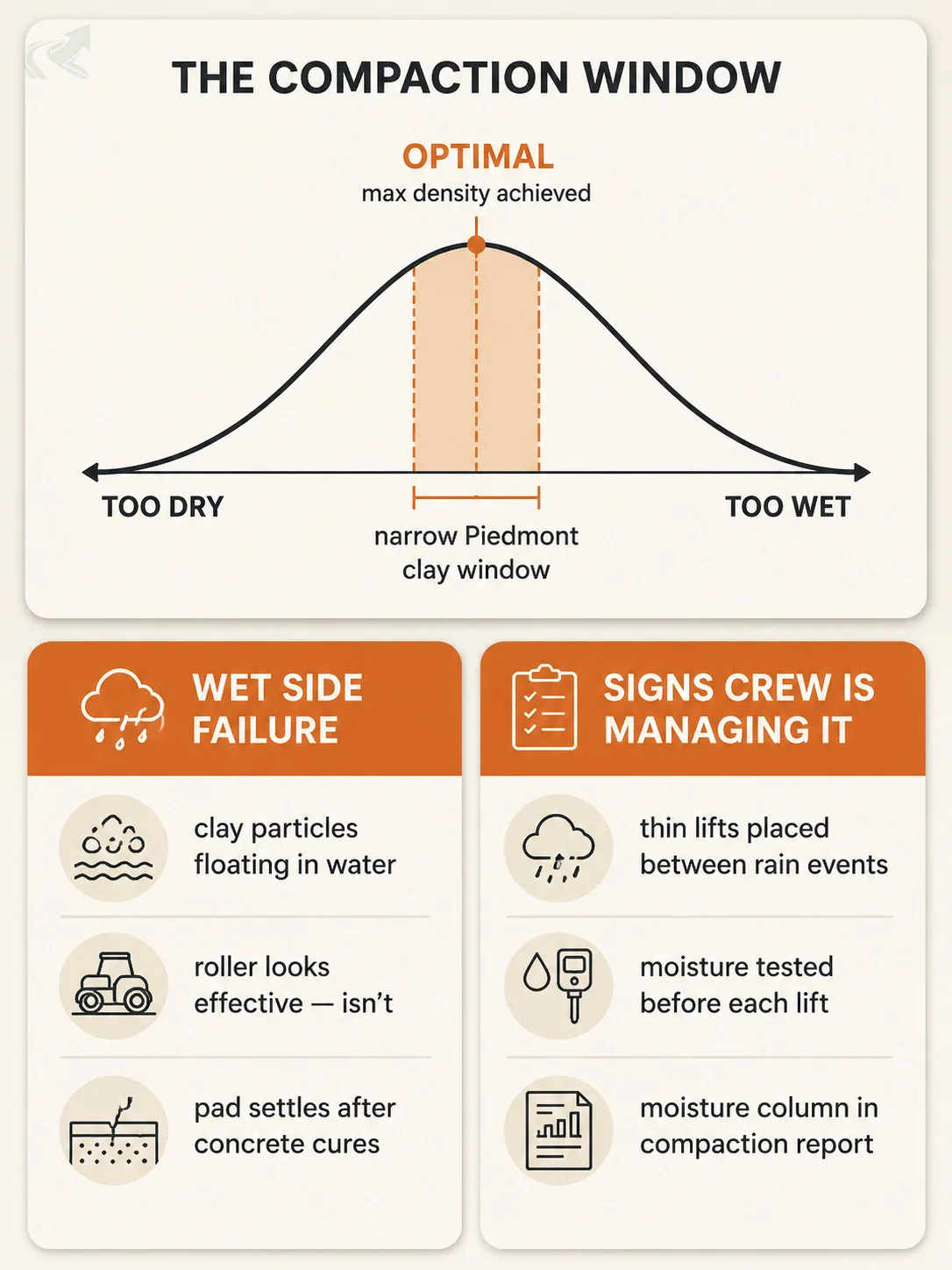

Bento-grid data-viz showing the NC Piedmont clay compaction moisture window as a bell curve, with cards explaining wet-side failure symptoms and signs a crew is managing moisture correctly.
Piedmont clay has a narrow optimal moisture range — the wet side is where most NC pad failures happen. A compaction report without a moisture-content column can’t tell you whether the crew hit the window.

What a Completed Pad Should Look Like

A correctly prepared NC building pad has four visible characteristics: uniform surface without soft zones, positive drainage slope away from the structure, no standing water at the perimeter, and consistent color indicating uniform moisture.

Before the pour, walk the perimeter. Here is what to look for:

This is what you are looking for before you agree that the pad is ready for concrete. For proof-rolling and compaction details for building pads, the compaction spoke covers the technical specs at deeper depth.


This hub explains what pad preparation involves. The spoke pages cover specific situations.

Both spokes link back here for the foundational fill-compaction-proof-roll sequence.


Find a Verified NC Grading Contractor

If you need a contractor who can document pad preparation correctly — compaction test report, proof-roll if required, lift log — the NC Grade and Haul directory lists verified North Carolina grading contractors by region.

Every contractor listed has been cross-referenced against the NC Licensing Board for General Contractors, OSHA records, and workers’ compensation filings. Listings show the verification tier and the underlying source data — so you can see what was checked, not just a badge.

Pad preparation is a quality-of-execution problem as much as a materials problem. The crew’s judgment on moisture timing, lift thickness, and whether to call a stop when conditions are wrong is what separates a pad that settles from one that holds for 30 years. An itemized quote from a contractor who includes compaction testing as a line item — not an afterthought — is what to look for.

Find a grading operator in North Carolina and ask for the compaction test protocol before you sign.
