GRADING

Site Grading & Preparation in North Carolina

NC site grading excavator shaping red Piedmont clay beside a silt fence.

Two questions people often ask

Do I need a permit for grading and excavating in NC?

Usually yes — but it's three separate programs, not one. NC's E&S Act triggers at 1 acre of disturbance. Charlotte/Mecklenburg's post-construction stormwater permit triggers at 5,000 sq ft of new built-upon area — even on under-1-acre sites. And watershed-overlay buffers can apply at any size. Your contractor should know all three before the bucket touches dirt.

How do I tell a real grading contractor from a guy with a tractor?

Ask three things. (1) What's the land-disturbance threshold in my county. (2) How will you handle silt fence and the stabilized construction entrance. (3) Will the proof-roll be documented. A legitimate operator answers all three without hesitation.


Grading in NC covers everything from a single new-home pad to an acre of lot prep to a small commercial site. What they share: if you disturb more than a threshold amount of soil, the NC E&S Act applies, and ignoring it is how contractors end up with a stop-work order taped to the silt fence.

This hub maps the site-prep work we do, the NC regulations that apply, and where to start based on what you’re actually trying to build. The regulatory section comes first on purpose — most contractor sites pretend it doesn’t exist, then leave the homeowner holding the enforcement bag.


What “Grading” Actually Means in NC

Five different jobs share the word. Pad grading, lot prep, regrading, driveway grading, and erosion control — different scope, different code, different price.

A homeowner asks for “grading” and means one of five distinct things. A contractor who quotes all five the same way is either inexperienced or rounding up. Here’s the breakdown:

Pad grading and driveway grading are not the same thing. If a quote treats them as interchangeable, that’s the first signal to slow down.

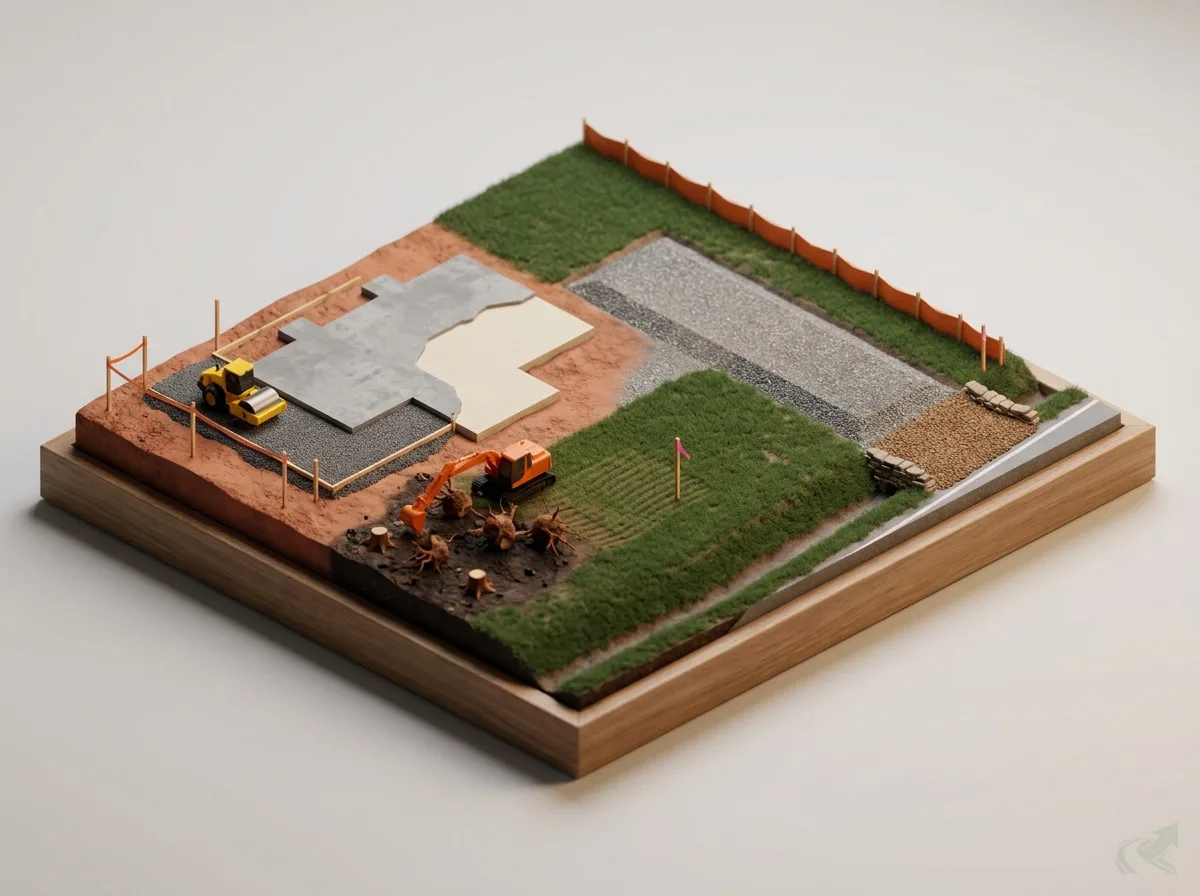

Isometric diorama of a single residential lot divided into five grading zones: pad grading with a roller compacting aggregate base, lot prep with an excavator grubbing stumps, regraded lawn sloping away from the house, driveway subgrade with a crowned gravel surface, and an orange silt fence perimeter for erosion control
All five grading jobs on one lot — pad, lot prep, regrade, driveway subgrade, and erosion control — each a different scope, different code, different price. A quote that lumps them together is a quote that hasn’t been thought through.

NC Erosion & Sediment Control — The Rule Most Sites Skip

The NC Sedimentation Pollution Control Act requires an approved E&S plan for any land disturbance of 1 acre or more. Many counties trigger sooner. Skipping it exposes you — the property owner — to enforcement.

The state floor is one acre. That’s set by the -administered Sedimentation Pollution Control Act. But “1 acre” is the ceiling for ignoring it, not the floor — most counties set lower local triggers under their own ordinances:

Factor State erosion control (E&S Act)Charlotte / Mecklenburg post-construction stormwaterWatershed overlay buffers (state-wide)
What triggers it Disturbing 1 acre or more (43,560 sq ft) on a tractCreating 5,000 sq ft or more of new built-upon area (even on under-1-acre sites)Any disturbance within a designated water-supply or critical-area watershed buffer (varies by overlay)
What's required Erosion & Sediment Control Plan filed with DEMLR or delegated local authority 30+ days before work startsStormwater Management Permit through local stormwater services (SCM design, runoff calcs, post-construction inspection)Buffer-impact review + density/BUA caps; mitigation or SCMs required for buffer impacts
Who enforces NCDEQ DEMLR regional office or delegated local programCharlotte-Mecklenburg Stormwater Services (Article 25); county equivalents elsewhereLocal zoning / watershed administrator; state oversight via 15A NCAC 02B .0211 et seq.
Stop-work risk if skipped Stop-work order + civil penalty up to $5,000 per day of continuing violation (G.S. 113A-64)Stop-work + permit hold + as-built submittal + per-day enforcementStop-work + buffer-restoration order + watershed-violation surcharge

What triggers it

State erosion control (E&S Act)
Disturbing 1 acre or more (43,560 sq ft) on a tract
Charlotte / Mecklenburg post-construction stormwater
Creating 5,000 sq ft or more of new built-upon area (even on under-1-acre sites)
Watershed overlay buffers (state-wide)
Any disturbance within a designated water-supply or critical-area watershed buffer (varies by overlay)

What's required

State erosion control (E&S Act)
Erosion & Sediment Control Plan filed with DEMLR or delegated local authority 30+ days before work starts
Charlotte / Mecklenburg post-construction stormwater
Stormwater Management Permit through local stormwater services (SCM design, runoff calcs, post-construction inspection)
Watershed overlay buffers (state-wide)
Buffer-impact review + density/BUA caps; mitigation or SCMs required for buffer impacts

Who enforces

State erosion control (E&S Act)
NCDEQ DEMLR regional office or delegated local program
Charlotte / Mecklenburg post-construction stormwater
Charlotte-Mecklenburg Stormwater Services (Article 25); county equivalents elsewhere
Watershed overlay buffers (state-wide)
Local zoning / watershed administrator; state oversight via 15A NCAC 02B .0211 et seq.

Stop-work risk if skipped

State erosion control (E&S Act)
Stop-work order + civil penalty up to $5,000 per day of continuing violation (G.S. 113A-64)
Charlotte / Mecklenburg post-construction stormwater
Stop-work + permit hold + as-built submittal + per-day enforcement
Watershed overlay buffers (state-wide)
Stop-work + buffer-restoration order + watershed-violation surcharge

These are three separate programs with three different triggers. A site can be under 1 acre and still need a stormwater permit if it creates 5,000+ sq ft of new built-upon area. A site can be 0.5 acre and still need buffer review if it touches a protected watershed. A contractor who only checks one program is checking a third of the regulatory surface.

Three independent gates

Each program has its own trigger. They do not nest — one job can trip any combination.

State E&S Act

Triggers at 1 acre or more disturbed

Local stormwater permit

Triggers at 5,000+ sq ft of new built-upon area — even on under-1-acre sites

Watershed buffer review

Applies at any project size if your lot touches a protected watershed

A project can trip one, two, or all three at once. A contractor who checks only one is checking a third of the rules.

A proper E&S plan, executed on the ground, includes the predictable kit:

A contractor who skips this isn’t saving you money. They’re handing the enforcement risk to you as the property owner — the violation attaches to the parcel, not the LLC. For the full code walkthrough see NC erosion code and the NC Sedimentation Pollution Control Act reference. Other NC regulations that touch grading work live at NC regulations.

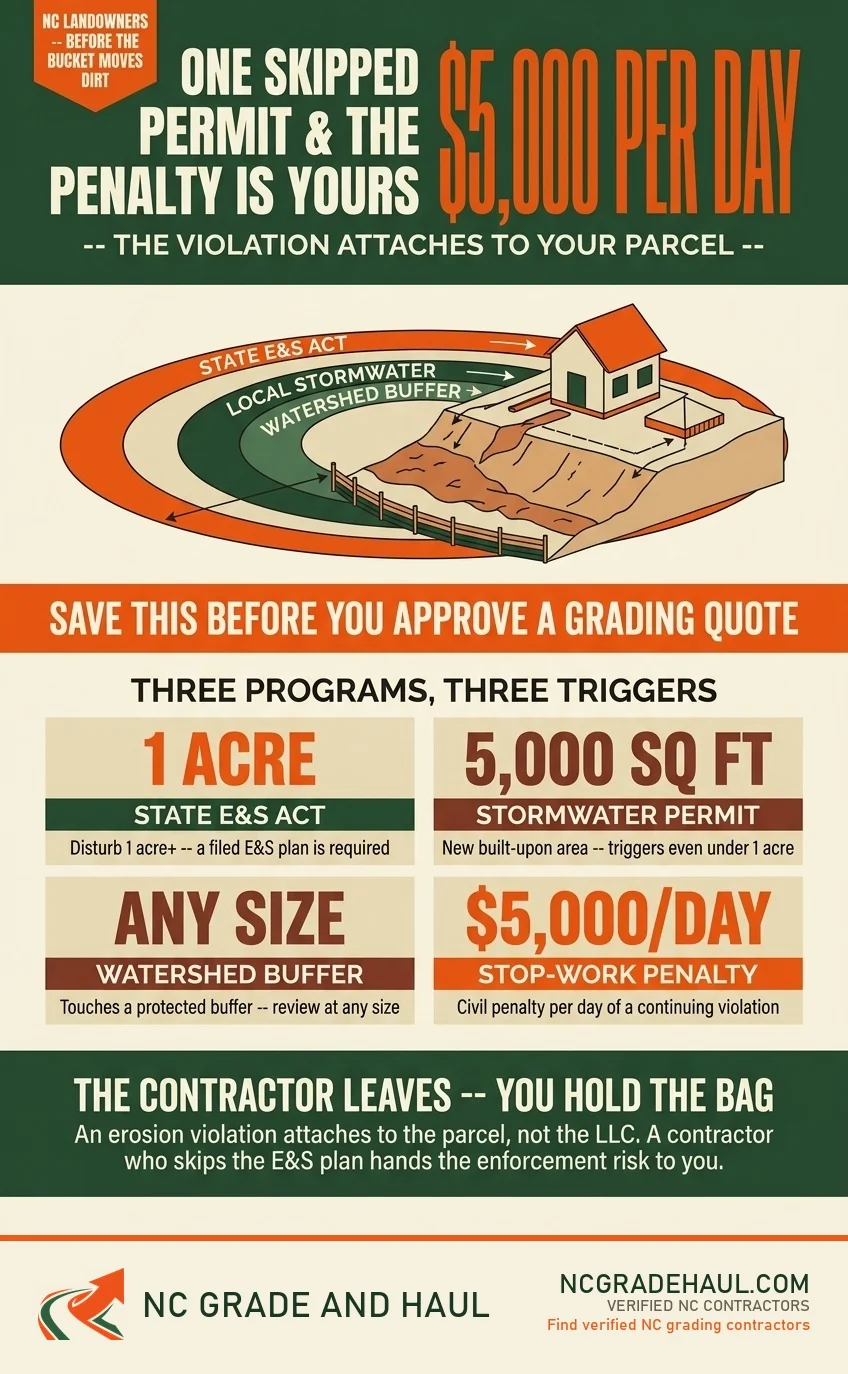

Save this before you approve a grading quote -- the three regulatory programs most contractor sites skip.

Pad Grading for New Homes — Where Production Builds Fail

The most common new-build drainage failure starts at the pad. Backfill compaction gets rushed, the perimeter drain is under-spec’d or missing, and the grade is set after the sod truck shows up. The drainage problem you’re calling about a year later started here.

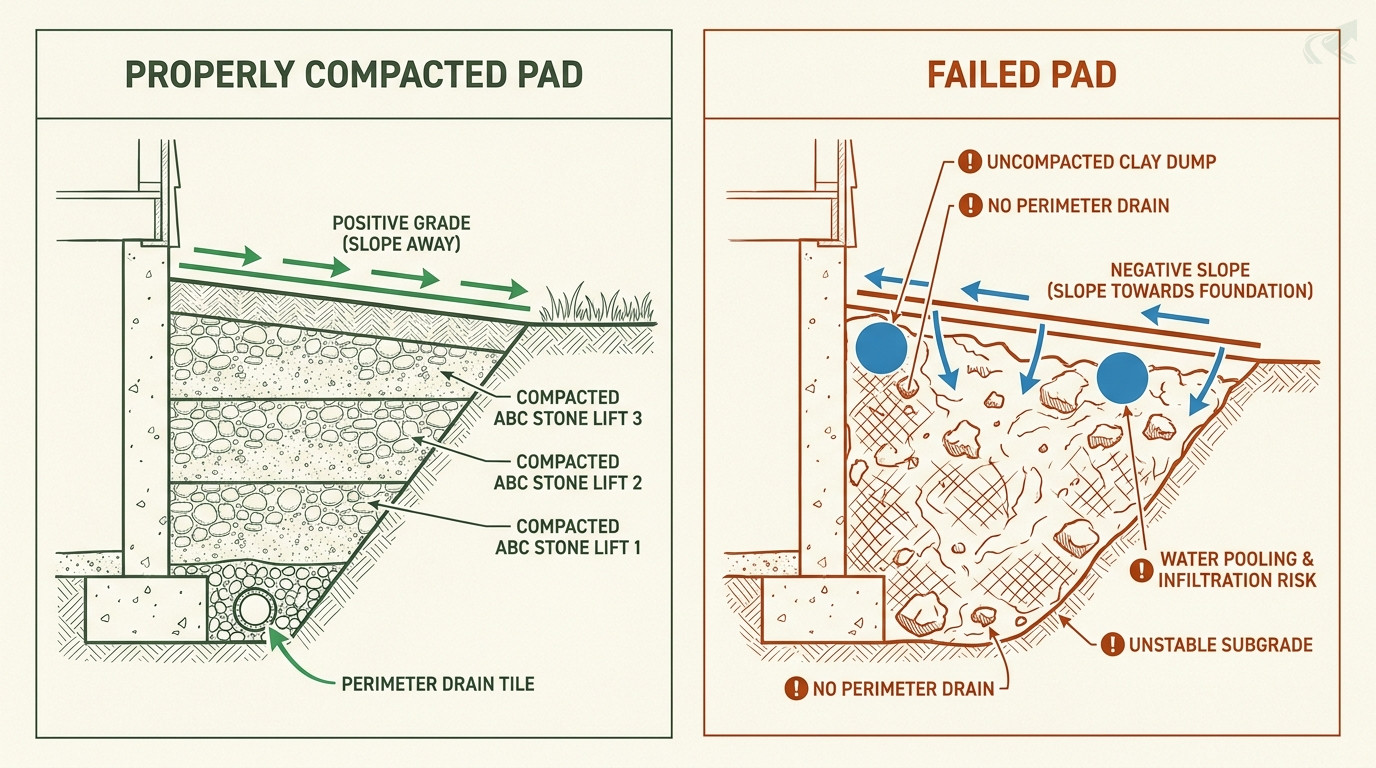

Two-panel cross-section comparison: left panel shows properly compacted pad with distinct ABC stone lifts, perimeter drain tile at footing, and positive grade sloping away from foundation; right panel shows failed pad with single uncompacted red clay dump, no drain, and water pooling against foundation wall
Left: what a correctly built pad looks like. Right: what most production-build pads actually are. The drainage problem you call about a year later started at the right panel.

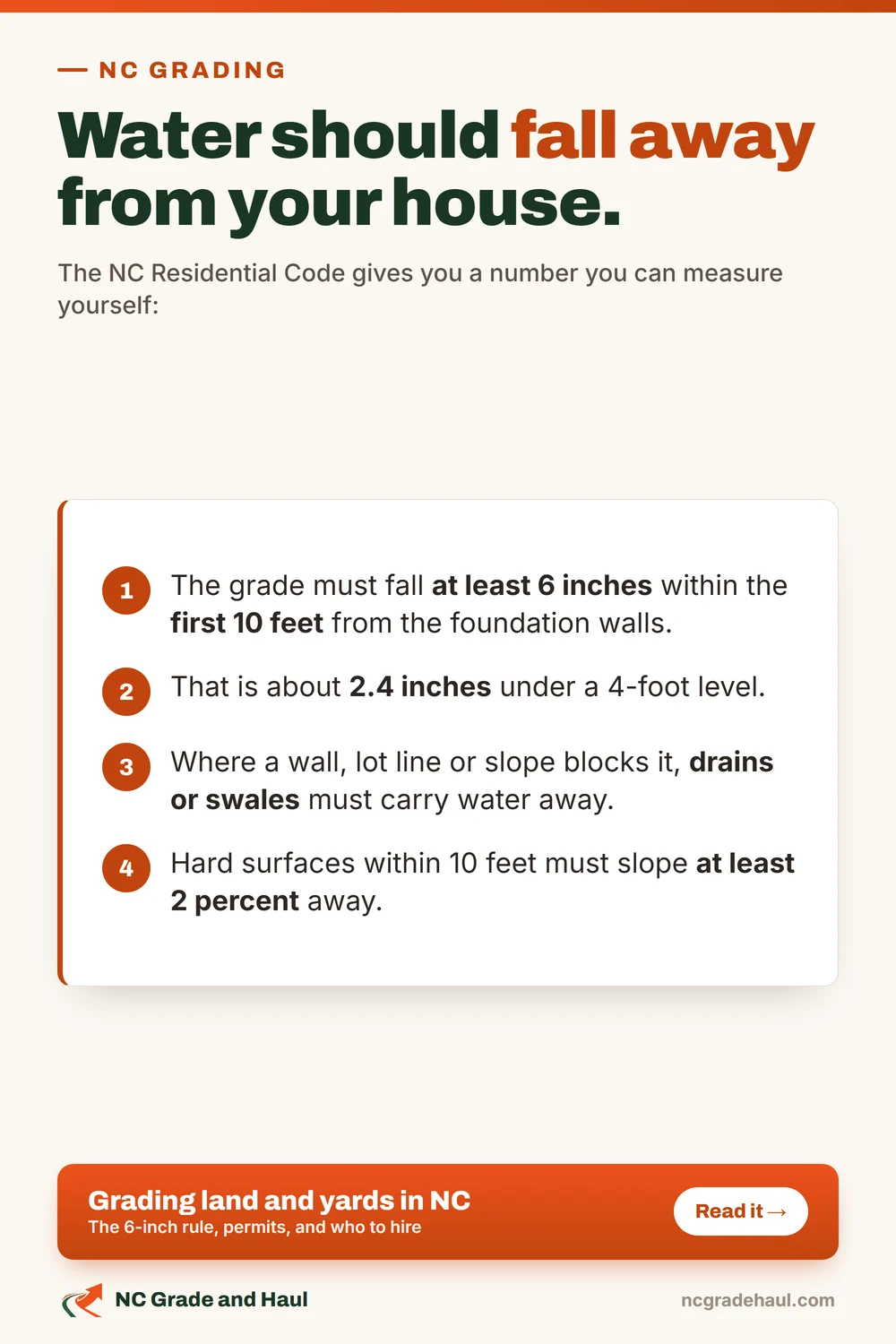

A pad graded right is unglamorous: cut and fill to engineered elevation, compaction in lifts (not one big dump), proof-roll with a loaded truck or roller, and final grade sloped at minimum 6 inches in the first 10 feet away from the foundation per NC Residential Code. The or structural fill is placed in the right thickness for the soil — Piedmont red clay punishes shortcuts here, because clay swells when wet and shrinks when dry, and a poorly compacted lift moves with the seasons.

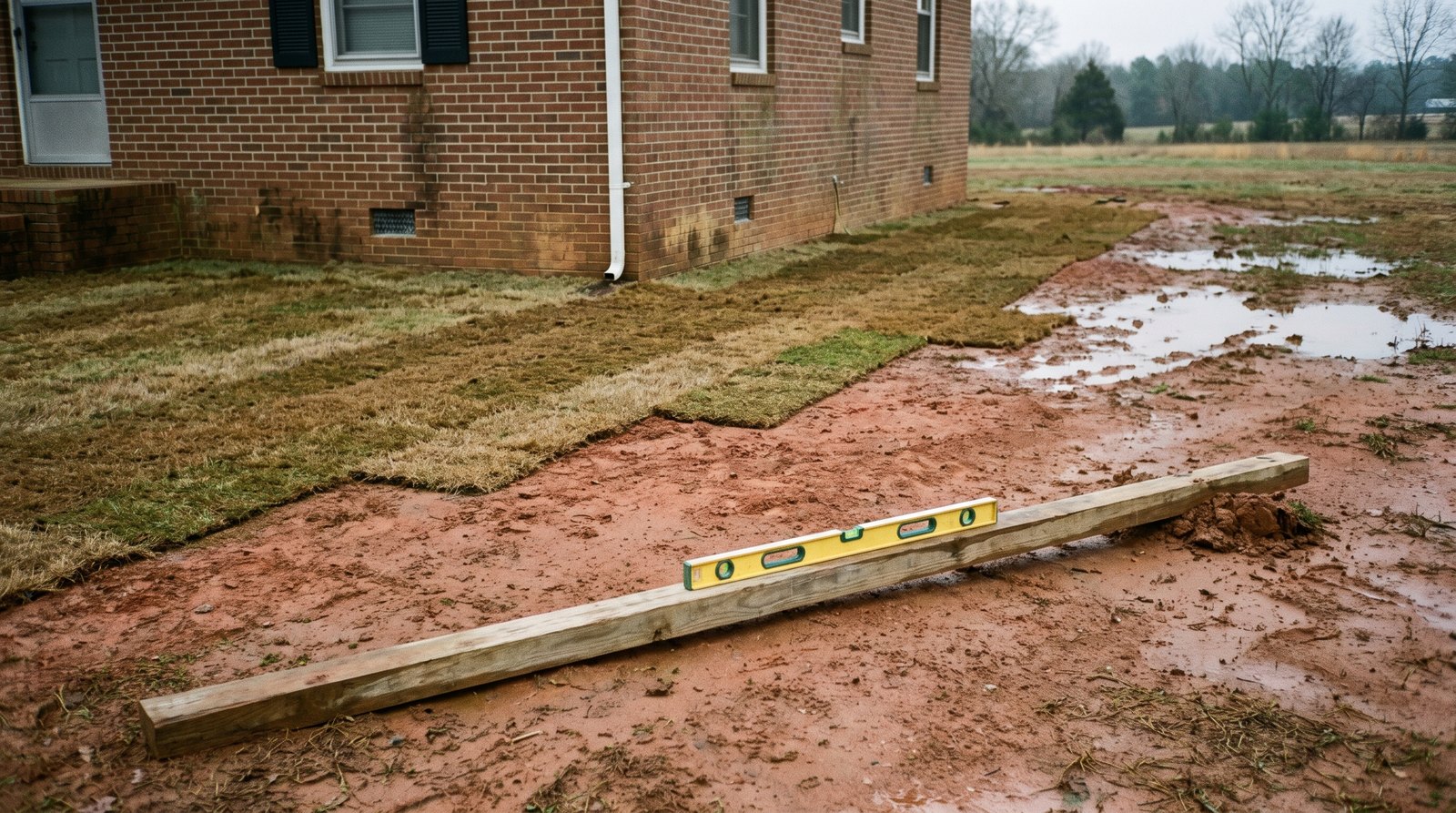

The production-build failure pattern is consistent across Triangle and Charlotte-metro neighborhoods: backfill against the foundation is the same red clay that came out of the hole, dropped in by trackhoe, barely tamped. Six months later the homeowner has standing water at the garage corner and a musty crawl-space smell.

The grading subcontractor is gone. The warranty contractor is unhelpful. The homeowner pays twice — once in the original price of the house, once to fix what should have been done right.

If this is the call you’re about to make, start at the new-home pad page for the spec, then the foundation drainage playbook for the enforcement levers when the builder won’t respond.


Hiring a Grading Contractor

Three questions screen out 90% of bad quotes. Land-disturbance threshold for the county. E&S install plan. Proof-roll documentation.

A real operator answers all three on the first call. A real operator also gives you an itemized quote — line items for clearing, E&S install, cut/fill yardage, compaction, and final grade — not a single round number. Single-line quotes hide what you’re actually paying for and make change orders inevitable.

Walk through the full hiring checklist, including what an itemized quote should look like and what a Certificate of Insurance must show before any equipment hits your lot, at NC grading contractor services and vetting guide.
