GRADING

Rough Grading vs Finish Grading in NC: Sequence, Tolerances, and When Each Phase Happens

NC rough vs finish grading bulldozer and skid steer on same clay lot.

The question every grading quote raises

What is the difference between rough grading and finish grading?

Rough grading is the earthwork -- bulldozer work that establishes grade, cut-and-fill balance, and drainage flow. Finish grading is the final surface pass -- typically after utilities and before landscaping -- that creates a seed-ready or hardscape-ready surface at final elevation. Both are required on most North Carolina construction projects.

If my quote says 'rough grade only,' what am I missing?

You are missing the finish grading phase. Rough grade leaves the lot graded for drainage but not ready for sod, seed, or hardscape. You will need a separate finish grade pass before landscaping -- done by the same contractor at a different stage of the build, or a second crew entirely.


Two contractors quote your lot. One says “rough grade.” One says “rough and finish grade.” The price gap is real — and so is the scope gap. Before you can evaluate which quote is the better deal, you need to know what each phase actually covers.

This page breaks down both phases, when each happens relative to other trades, what tolerances they hit, and the one sequencing mistake that causes visible yard failures 12 months after move-in.

Rough grading vs finish grading: NC sequence, tolerances, when each phase happens — and why finishing the yard before settlement is the most expensive shortcut a builder takes.
Two phases, two crews, two different jobs.

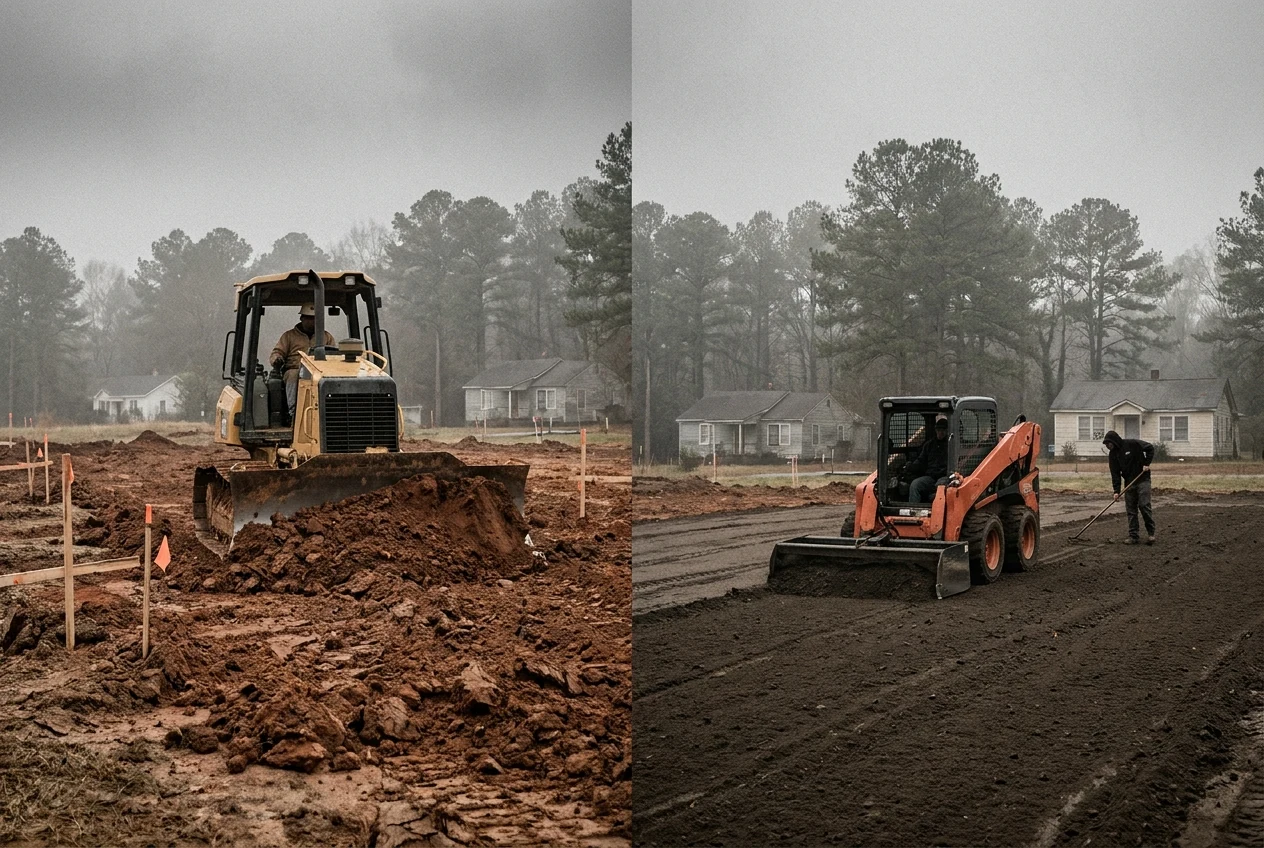

Split documentary photo: a bulldozer cutting rough uneven red clay with grade stakes on the left, a skid steer with a box blade and a worker raking a smooth seed-ready surface on the right.
Rough grading shapes the lot for drainage; finish grading is the final smoothing pass that leaves a seed-ready surface at exact elevation.

What Rough Grading Is

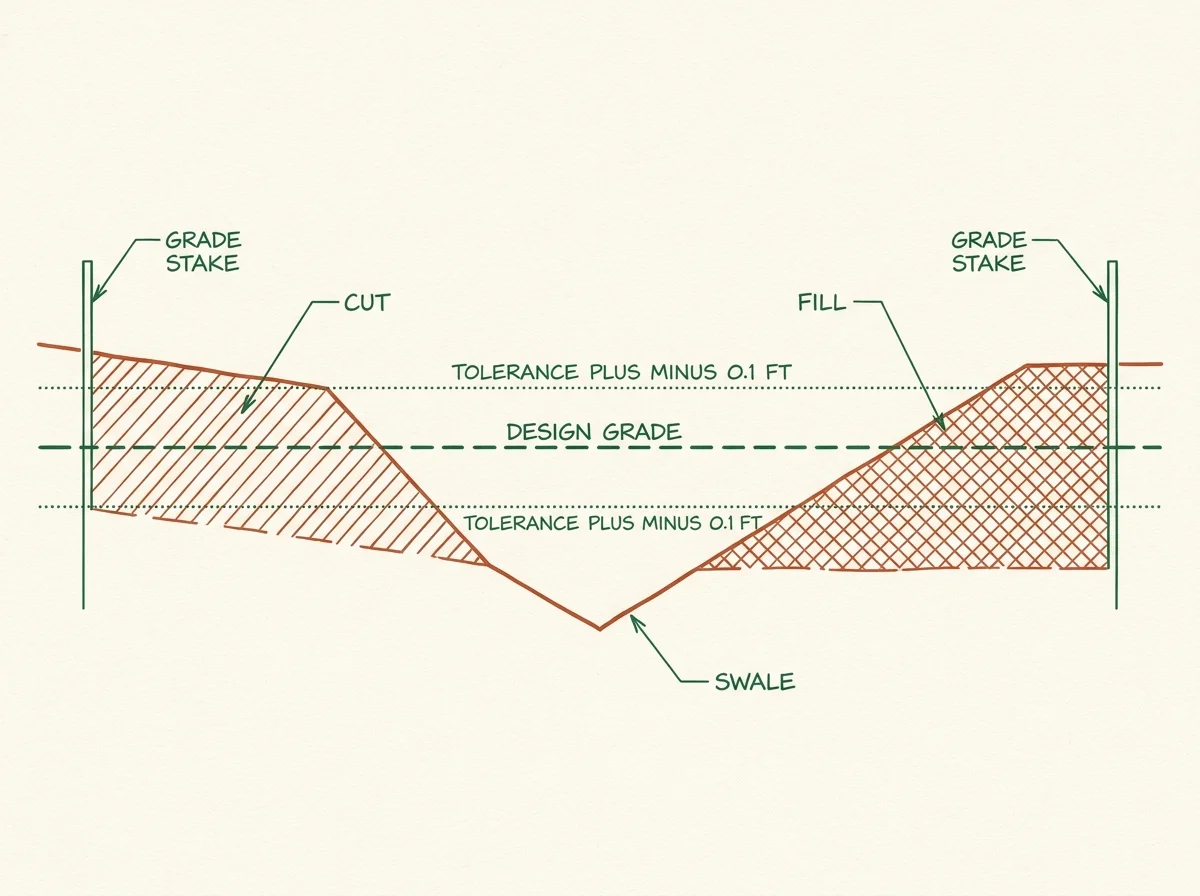

Technical cross-section diagram showing a residential lot at rough grade: cut zone on the left with diagonal terracotta hatching, fill zone on the right with cross-hatch, a V-shaped drainage swale at center, and a dashed Design Grade reference line with plus-or-minus 0.1 ft tolerance bands above and below. Grade stakes at each edge.
Rough grade cross-section: cut and fill zones establish drainage flow, with a tolerance of plus-or-minus 0.1 ft from design grade.

Rough grading is the bulk earthwork — cut, fill, drainage establishment, and pad formation — that shapes the lot to design grade.

A bulldozer (and sometimes a motor grader on larger lots) does the heavy moving. Soil is cut from high spots and pushed to low spots to balance the site. Swales and positive drainage paths are rough-cut to direct water away from the foundation and off the property.

Rough grade tolerance in residential work is typically within plus-or-minus 0.1 feet of design grade — the same tolerance NCDOT permits in a roadbed after it has been graded to a uniform surface. That is 1.2 inches — close enough for drainage to function, but not close enough for sod or concrete flatwork.

Rough grading happens early — usually right after land clearing in NC for construction and before any utility installation. It is the foundation everything else builds on. Once utilities go in the ground, rough grade is done.


What Finish Grading Is

Finish grading is the final 6-12 inch surface pass that creates a seed-ready and sod-ready, or hardscape-ready, surface at the precise final elevation.

Equipment changes at this stage. A skid steer with a box blade and a hand rake crew takes over from the bulldozer. The goal is a smooth, correctly-sloped surface with no high spots, no low spots, and no undulations that will hold water or cause an uneven seed bed.

Finish grade tolerance is tighter. For concrete flatwork and hardscape, the controlling standard is ACI 117 — the fine grade of soil immediately below a slab-on-ground is held to plus-or-minus 3/4 inch, tightened to plus-or-minus 1/2 inch when the specifier calls for it. For seed and sod, finish grade is typically worked to within roughly half an inch to an inch of design elevation — an industry working estimate, not a published code tolerance. That tolerance is the difference between a flat driveway and one that holds puddles at the edges.

Finish grading also corrects any minor drainage issues that appeared after utility installation. Trenches settle. Compaction isn’t always even. Finish grade is the phase where those problems get fixed before the surface goes down.


The Sequence — When Each Phase Happens in Construction

NC residential construction sequence: where each grading phase falls

1. Land clearing -- Trees, stumps, and brush removed -- site ready for earthwork. 2. Rough grading -- Cut and fill, drainage establishment, pad formation. Tolerance: +/- 0.1 ft. 3. Underground utilities -- Plumbing rough, electrical conduit, drainage lines installed in trenches. 4. Pad and foundation -- Slab pour or crawl space preparation on the rough-graded subgrade. 5. Structure and framing -- Framing, roof -- the building takes shape above the graded lot. 6. Finish grading -- Final surface pass after utilities settle. Tolerance: +/- 1/2 to 3/4 in. Seed-ready or hardscape-ready.

  1. Land clearing

    Trees, stumps, and brush removed -- site ready for earthwork.

  2. Rough grading

    Cut and fill, drainage establishment, pad formation. Tolerance: +/- 0.1 ft.

  3. Underground utilities

    Plumbing rough, electrical conduit, drainage lines installed in trenches.

  4. Pad and foundation

    Slab pour or crawl space preparation on the rough-graded subgrade.

  5. Structure and framing

    Framing, roof -- the building takes shape above the graded lot.

  6. Finish grading

    Final surface pass after utilities settle. Tolerance: +/- 1/2 to 3/4 in. Seed-ready or hardscape-ready.

Rough grade and finish grade are typically 6-12 weeks apart on an NC residential build. Utility trench backfill must settle before the finish grade pass.

NC Grade and Haul ncgradehaul.com

Rough grade happens first. Finish grade happens last — after utilities are in the ground and the structure is framed.

Here is the construction sequence on a typical North Carolina residential build:

  1. Land clearing — trees, stumps, brush removed
  2. Rough grading — cut and fill, drainage, pad formation
  3. Underground utilities — plumbing rough, electric conduit, any underground drainage
  4. Pad and foundationNC rough grade to pad sequence and slab or crawl space preparation
  5. Structure — framing, roof
  6. Finish grading — final surface pass, seed bed or hardscape prep

Finish grade cannot happen after Step 3. Utility trenches — especially plumbing and French drain lines — must be backfilled and settled before any finish surface work. A finish grade over fresh utility backfill will settle unevenly within one growing season.

On most NC residential lots, rough grade and finish grade are 6-12 weeks apart. On smaller lots with tight timelines, that window compresses — but the sequencing constraint does not change. See grading sequencing with other trades in North Carolina for the full dependency map.


Why Finish Grading After Sod Is Wrong

Sod placed on a rough-graded surface that was never finish-graded will develop visible low spots, standing water, and uneven settling within 12 months.

This is the most common builder shortcut in North Carolina residential construction. The lot gets rough-graded, utilities go in, the house gets framed — and then landscaping crews lay sod directly on the rough-graded surface to make the lot look finished for closing.

Here is what that looks like 12 months later: low spots near utility trenches where backfill settled. Water pooling at the foundation perimeter where the rough grade never got corrected. Sod edges lifting at the transition between the builder-laid surface and the neighbor’s lot because the grade was never dialed in.

The fix costs more than the finish grade would have — yard regrading vs finish grading NC is a different mobilization, and lifting sod, resurfacing, and relaying carries a higher unit cost than doing it right in sequence. And by then, the builder has been paid and moved on.

Finish grading also sets the elevation for walkways, patios, and driveways. If sod goes down first, hardscape contractors are forced to match an incorrect surface — which is why slab-on-grade transitions sometimes end up with a 2-3 inch step that was never in the design.

Sod on a finish-graded surface vs sod on rough grade

Comparison. Done in sequence: Rough grade, then utilities, then a finish grade pass; Sod laid on a smooth surface at final elevation; Positive slope away from the foundation holds; Yard still reads true 12 months after move-in. Finish grade skipped: Sod laid straight onto the rough-graded surface; Low spots over utility trenches as backfill settles; Water pools at the foundation perimeter; Sod edges lift; the fix costs more than the skipped phase.

Done in sequence
  • Rough grade, then utilities, then a finish grade pass
  • Sod laid on a smooth surface at final elevation
  • Positive slope away from the foundation holds
  • Yard still reads true 12 months after move-in
Finish grade skipped
  • Sod laid straight onto the rough-graded surface
  • Low spots over utility trenches as backfill settles
  • Water pools at the foundation perimeter
  • Sod edges lift; the fix costs more than the skipped phase

Sod laid before a finish grade pass develops visible low spots and standing water within one growing season.

NC Grade and Haul ncgradehaul.com

Rough vs Finish Grading at a Glance

Rough grading vs finish grading -- key differences for North Carolina residential projects

Factor Rough gradingFinish grading
Timing in build Early -- after clearing, before utilitiesLate -- after utilities, before landscaping
Primary equipment Bulldozer, motor graderSkid steer, box blade, hand rake
Grade tolerance +/- 0.1 ft (NCDOT roadbed standard)+/- 1/2 to 3/4 in. for slab subgrade (ACI 117); ~1/2-1 in. for seed/sod
Surface result Drainage and grade established, pad formedSeed-ready or hardscape-ready surface
Included in 'site prep' quotes? Usually yesNot always -- verify in writing
Can it follow utility installation? Yes -- it precedes utilitiesNo -- must wait until utilities are in and settled

Timing in build

Rough grading
Early -- after clearing, before utilities
Finish grading
Late -- after utilities, before landscaping

Primary equipment

Rough grading
Bulldozer, motor grader
Finish grading
Skid steer, box blade, hand rake

Grade tolerance

Rough grading
+/- 0.1 ft (NCDOT roadbed standard)
Finish grading
+/- 1/2 to 3/4 in. for slab subgrade (ACI 117); ~1/2-1 in. for seed/sod

Surface result

Rough grading
Drainage and grade established, pad formed
Finish grading
Seed-ready or hardscape-ready surface

Included in 'site prep' quotes?

Rough grading
Usually yes
Finish grading
Not always -- verify in writing

Can it follow utility installation?

Rough grading
Yes -- it precedes utilities
Finish grading
No -- must wait until utilities are in and settled

Which Phase Does Your Quote Actually Cover?

Read the scope section of every grading quote and look for the word “finish” — if it is not there, assume the quote is rough grade only.

Most residential grading quotes describe scope in one of three ways:

The three questions to ask any NC grading contractor before signing:

Does this quote include rough grade only, or both rough and finish grade? What is the tolerance specification for each phase? What trigger in the construction sequence determines when finish grade happens?

If the answer to the first question is “rough only,” that is not a problem — it just means finish grade is a separate work order. A clear itemized quote with both phases scoped and priced is better than a vague “full site grading” that might mean anything.

Hire a verified NC grading contractor who will put both phases on the quote. Evaluating grading quotes that include both phases covers what to look for in the scope and tolerance language.
