RESOURCES

Grading Permit Requirements in Wake, Mecklenburg, Durham, and Guilford Counties

NC grading permit inspector and contractor reviewing silt fence at a county culvert project

A homeowner in Wake County hires a grading crew. Work starts Monday. By Wednesday a county inspector is on site with a stop-work order.

The project halts three weeks while the contractor files an plan that should have been filed first. The contractor knew. The subcontractor knew. The homeowner — paying for all of it — was the last to find out.

That happens because NC grading permits are county-administered, not state-administered. No single portal. No standardized acreage trigger. No universal terminology. Four counties, four separate systems.

Below is the matrix. After that, each county gets a quick-read card with its threshold, portal, and the local gotcha.


How NC Permitting Layers Work

State permit triggers at 1 acre of land disturbance. County permits trigger much sooner — and apply to most residential projects.

State layer. administers the statewide permit under NC General Statute Chapter 113A. The trigger: 1 acre of land disturbance. Below 1 acre, no state permit — but the county layer usually applies.

County layer. Each county sets its own lower land-disturbance threshold. Some trigger at a specific square footage. Some at any grading near a stream buffer. Some at any alteration of positive drainage. A project that’s clear in one county can need a full E&S review in the next one over.

The terminology problem. Wake calls it a Land-Disturbance Permit. Mecklenburg calls it a Grading Permit. Durham uses Grading/E&S Plan. Guilford uses the same name as Wake — different agency, different thresholds. Same category of approval; different paperwork.

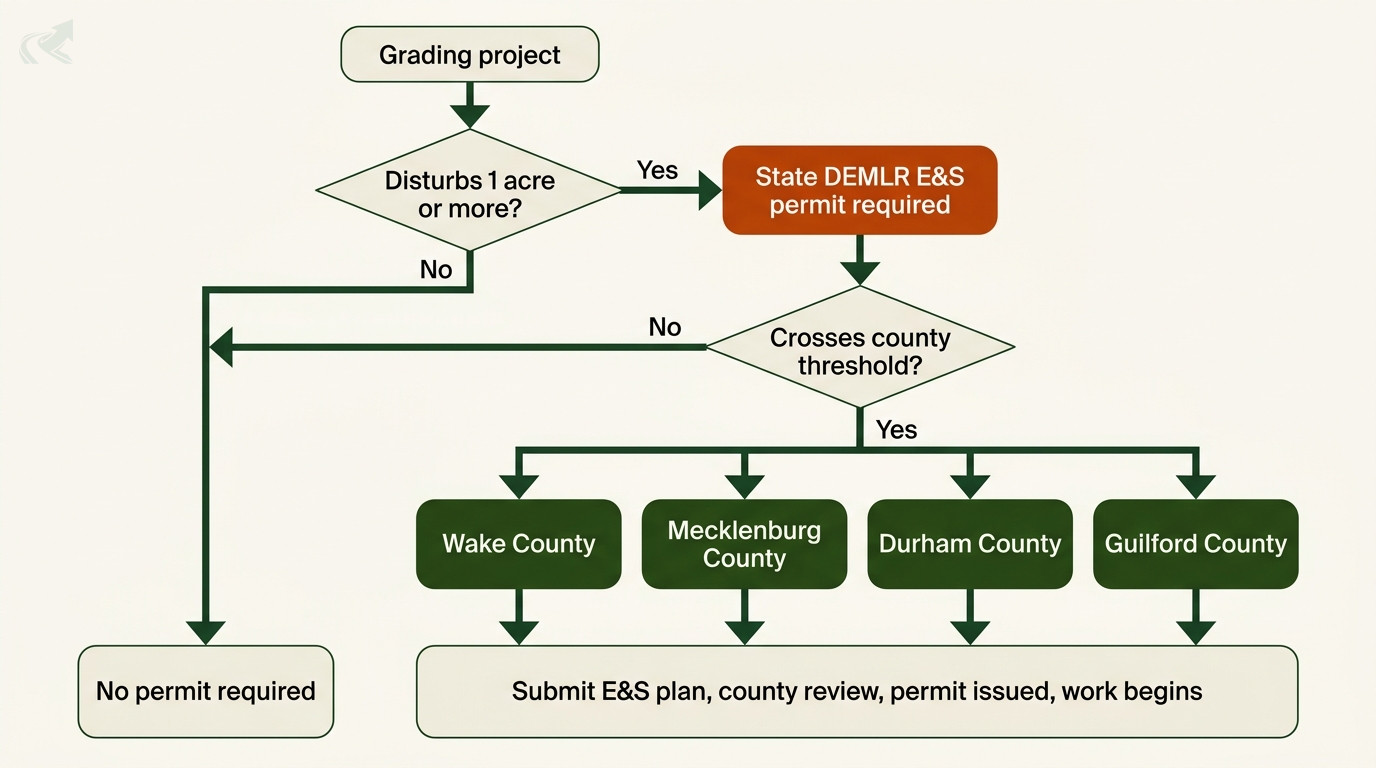

Flowchart of NC grading permit two-layer decision tree: a project that disturbs 1 acre or more triggers a state DEMLR E&S permit (terracotta node); below 1 acre or above the state trigger, a second decision asks whether the project crosses the county threshold, branching into Wake, Mecklenburg, Durham, or Guilford county permits (forest-green nodes), all of which converge on licensed-contractor submission and county review. The No branch from the county-threshold decision leads to a No-permit-required terminal.

Two-layer NC grading permit decision tree — state DEMLR triggers at 1 acre; counties set lower thresholds independently. Both layers can apply to the same project.

For broader context see the NC Regulations hub and the stormwater ordinances reference.


Wake vs. Mecklenburg vs. Durham vs. Guilford — Side-by-Side

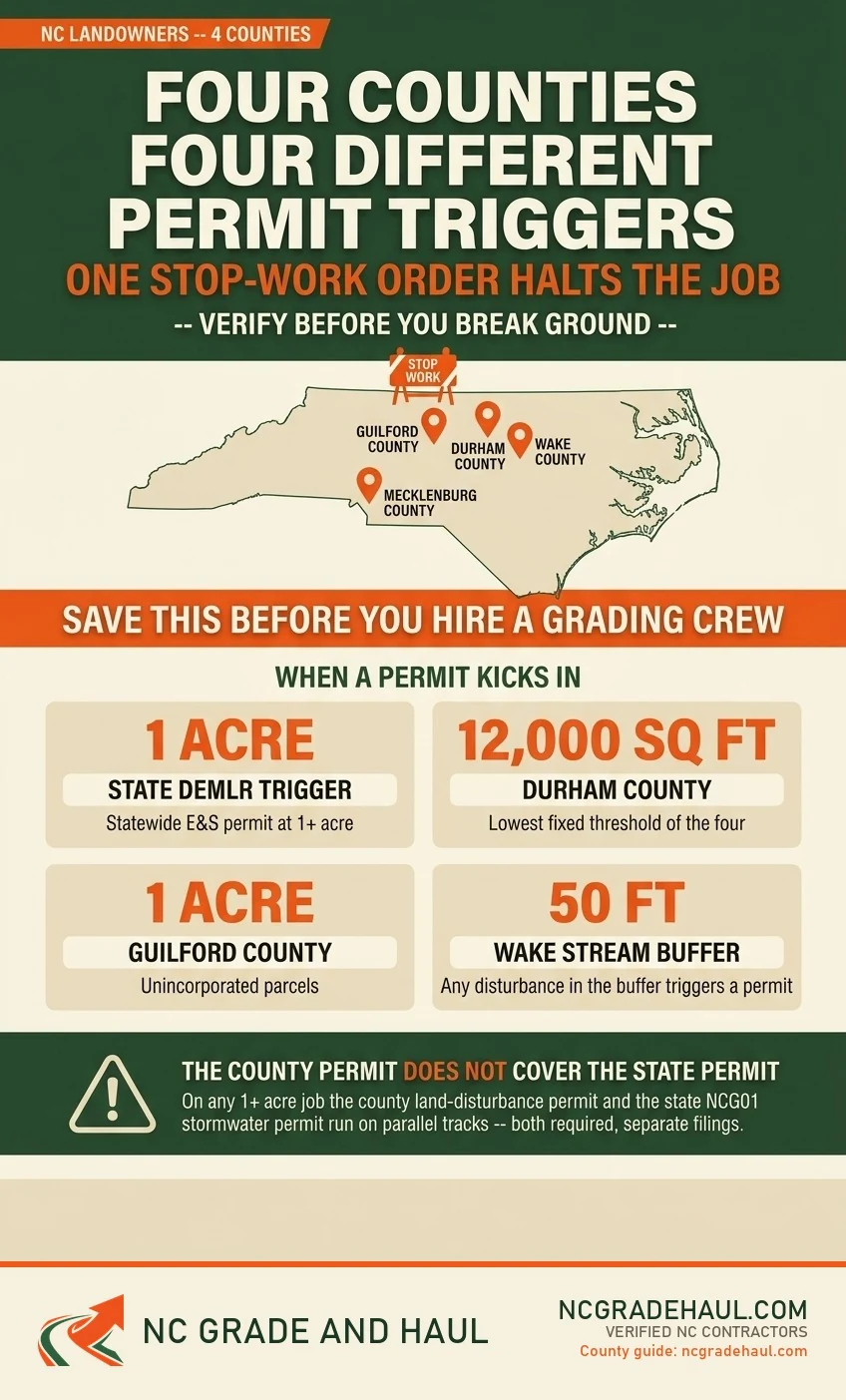

Four counties. Four different thresholds. Wake (unincorporated): any lot in a subdivision, or 1+ acre outside one; Raleigh city limits: 12,000 sq ft. Durham: 12,000 sq ft (UDO § 12.10.2). Guilford: 1 acre. Mecklenburg: verify at LUESA — threshold not publicly indexed in county ordinance text.

North Carolina counties, with Wake, Mecklenburg, Durham, Guilford highlighted Durham Guilford Mecklenburg Wake
The four NC counties this article covers — together they cover the Triangle (Wake + Durham), Charlotte metro (Mecklenburg), and Triad (Guilford).
Factor Wake CountyMecklenburg CountyDurham CountyGuilford County
Agency Wake Environmental Services — Stormwater & E&SMecklenburg LUESADurham City-County Planning Dept.Guilford Planning & Development
Permit name Land-Disturbance PermitGrading PermitGrading/E&S PlanLand-Disturbance Permit
Residential trigger Subdivision lot: any area; outside subdivision: 1+ acre; Raleigh city: 12,000 sq ft; stream buffer: any disturbanceVerify at LUESA — threshold not publicly indexed in county ordinance text12,000 sq ft (UDO § 12.10.2); full E&S plan required at 20,000+ sq ft1 acre (unincorporated county); Greensboro, High Point, Jamestown administer independently
Who applies Licensed contractorLicensed contractorLicensed contractorLicensed contractor
Portal Wake ePortal at wake.govLUESA Accela / WebPermitDurham Permits & InspectionsGuilford Planning & Development; Greensboro routes through city
Review time Verify at portalVerify at portalVerify at portalVerify at portal
Permit fee Scaled to acreage — verify at portalScaled to project scope — verifyVerify at portalVerify at portal

Agency

Wake County
Wake Environmental Services — Stormwater & E&S
Mecklenburg County
Mecklenburg LUESA
Durham County
Durham City-County Planning Dept.
Guilford County
Guilford Planning & Development

Permit name

Wake County
Land-Disturbance Permit
Mecklenburg County
Grading Permit
Durham County
Grading/E&S Plan
Guilford County
Land-Disturbance Permit

Residential trigger

Wake County
Subdivision lot: any area; outside subdivision: 1+ acre; Raleigh city: 12,000 sq ft; stream buffer: any disturbance
Mecklenburg County
Verify at LUESA — threshold not publicly indexed in county ordinance text
Durham County
12,000 sq ft (UDO § 12.10.2); full E&S plan required at 20,000+ sq ft
Guilford County
1 acre (unincorporated county); Greensboro, High Point, Jamestown administer independently

Who applies

Wake County
Licensed contractor
Mecklenburg County
Licensed contractor
Durham County
Licensed contractor
Guilford County
Licensed contractor

Portal

Wake County
Wake ePortal at wake.gov
Mecklenburg County
LUESA Accela / WebPermit
Durham County
Durham Permits & Inspections
Guilford County
Guilford Planning & Development; Greensboro routes through city

Review time

Wake County
Verify at portal
Mecklenburg County
Verify at portal
Durham County
Verify at portal
Guilford County
Verify at portal

Permit fee

Wake County
Scaled to acreage — verify at portal
Mecklenburg County
Scaled to project scope — verify
Durham County
Verify at portal
Guilford County
Verify at portal

Thresholds confirmed May 2026. Best-effort values based on historical practice. All four counties updated their between 2022 and 2025 — verify directly if you’re reading this 12+ months after publication.

When a grading permit kicks in across Wake, Mecklenburg, Durham, and Guilford -- and why the state layer is a separate filing.

What Every NC County Requires

Every county on this page wants the same four-piece submission. Per-county differences are in the threshold, the portal, and the local gotcha — not the package contents.


Wake County

Land-Disturbance Permit required for any lot within a subdivision (any area) and for projects disturbing 1+ acre outside a subdivision. In Raleigh city limits (separate jurisdiction), the trigger is 12,000 sq ft. Stream buffer grading triggers a permit regardless of area. Contractor pulls via Wake ePortal.

The trigger figure on the Wake ePortal supersedes any number here — confirm the effective date before bidding.

The gotcha: The stream-buffer rule catches a significant share of older Wake subdivisions where lots back up to mapped streams. Even a small backyard regrade can trigger a full Land-Disturbance Permit if it falls within the buffer. Verify the buffer map before signing any contract. For vetted Wake County grading contractors, this lookup is routine.

Stream buffer permit-trigger diagram Top-down view of a residential lot with the house at center, property line as a rectangle around it, a stream running along the back edge, a 50-foot regulated buffer band along the stream colored in muted terracotta, and a small backyard regrade zone shown in solid terracotta clipping into the buffer band — the geometry that triggers a Land-Disturbance Permit even on a sub-threshold project. Stream 50-FT REGULATED BUFFER House Backyard regrade clips buffer → PERMIT — property line —
A backyard regrade well under the 10,000 sq ft floor still triggers the permit if any disturbance falls inside the 50-ft stream buffer.

Mecklenburg County

Grading Permit at ~5,000 sq ft for new residential — the lowest threshold of the four counties here. Contractor pulls it via the Accela portal.

A backyard regrade that flies under Wake’s radar can still require a Mecklenburg Grading Permit. The Mecklenburg LUESA Accela portal is at aca-prod.accela.com/CHARLOTTE — account registration required, no public open-data lookup.

The gotcha: Unlike Wake, Mecklenburg does not publish permit data to a public catalog. Verifying whether previous work on a property was permitted requires the Accela portal or a direct call to LUESA. There is no shortcut here. Mecklenburg/Charlotte contractors familiar with Accela handle this routinely.


Durham County

Land-Disturbance Permit at 12,000 sq ft (Durham UDO § 12.10.2). Projects over 20,000 sq ft also require a full E&S plan submission. The lowest fixed threshold of the four counties — most residential regrading projects cross it.

Projects disturbing more than 12,000 sq ft need a Land-Disturbance Permit. Projects over 20,000 sq ft also require a full sedimentation and erosion control plan. Apply through Durham Permits & Inspections at durhamnc.gov/915.

The gotcha: Durham’s 12,000 sq ft floor is the lowest of the four counties here — lower than Wake’s subdivision-lot trigger at the margins, and much lower than Guilford’s 1-acre threshold. A contractor moving to Durham from another county may underestimate how quickly the permit requirement kicks in. When in doubt, the answer in Durham is almost always yes. Durham contractors used to the system file conservatively.


Guilford County

Land-Disturbance Permit at 1 acre of disturbance for unincorporated county parcels. Greensboro, High Point, and Jamestown each administer their own processes independently — confirm jurisdiction before applying. Plus state at 1+ acres (parallel tracks, not either/or).

Apply through Guilford Planning & Development for unincorporated land. Same permit name as Wake, different agency, different process.

The gotcha: Three-way jurisdictional split. Greensboro routes through City Engineering & Inspections. High Point and Jamestown each have their own processes. Only unincorporated county goes through Planning & Development. Filing at the wrong jurisdiction means rejection and delay. Confirm your project address’s jurisdiction before applying. Guilford/Greensboro contractors navigate this split daily.


Who Is Responsible for Pulling the Permit?

The licensed contractor — every time. If they tell you otherwise, that’s a red flag.

The contractor signs the E&S plan, lists their license number, and accepts legal liability for compliance. This is built into NC licensing thresholds and the county permitting structure. The contractor’s license number is on the permit; their bond is what makes the county whole if something goes wrong.

If a contractor tells you to pull the permit yourself for a project above the county threshold, one of three things is happening:

None of those are situations you want to be in after the equipment is mobilized.

Verify the license before you sign anything. The public portal at portal.nclbgc.org is free, no-account-required, searchable by company name or license number.

Exception: Homeowners who own the grading equipment and are performing the work themselves on their own land can apply for their own permit in most counties. Narrow carve-out — doesn’t apply to hired-contractor work.

Two questions cover both gates. Ask for the permit number before equipment mobilizes — that’s the legal-compliance gate. Ask to see the contractor’s current with your address listed as the project site — that’s the financial-protection gate. If either answer is “we’ll handle it later” or “trust me,” the contractor isn’t running a professional operation.

A contractor running a professional operation answers yes to both questions without hesitation. When you hire a grading contractor, this is the first thing on the vetting list — not an afterthought.


What a Missing Permit Actually Costs You

Stop-work order within hours. As-built fee typically 2x the base. Plus insurance and resale-disclosure exposure.

No horror stories required — the operational math is enough.

ConsequenceWhen it hitsTypical impact
Stop-work orderWithin hours of inspector visitProject halts; contractor mobilization costs continue to accrue while permit gets filed
As-built permitAfter unpermitted work discovered~2x base fee penalty; some counties require partial demolition + re-inspection before issuing
Homeowner insuranceAfter drainage-related claimCarrier may deny coverage on grounds that unpermitted work altered drainage patterns — documented risk, verify your policy
Resale disclosureAt sale (NC G.S. Chapter 47E)Required disclosure of known unpermitted work; buyer’s inspector finding it becomes negotiating wedge at closing

The permit line item on a contractor’s itemized quote — typically a few hundred dollars scaled to acreage — is worth every cent for exactly these reasons.

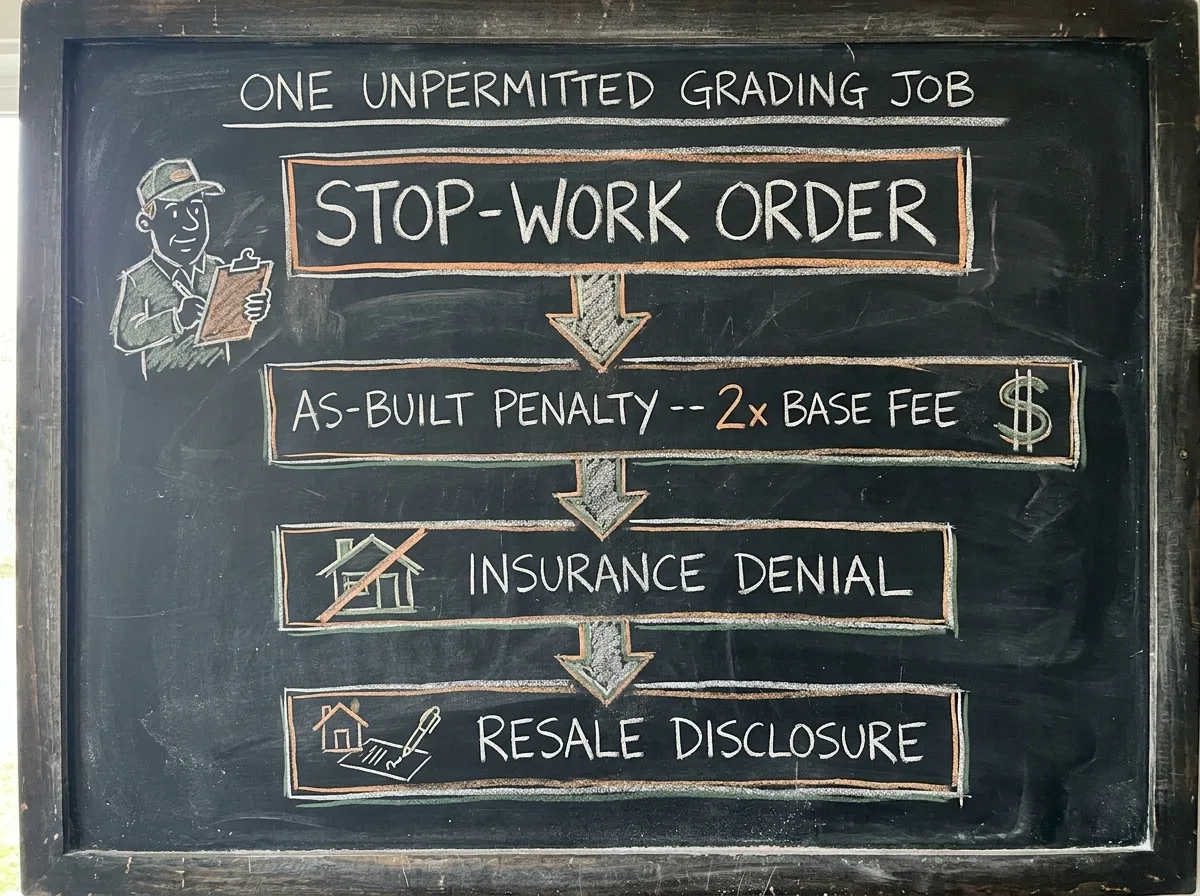

Chalkboard illustration showing the consequence cascade of a single unpermitted grading job: stop-work order at the top with an inspector figure, arrow down to as-built penalty at 2x base fee, arrow down to insurance denial, arrow down to resale disclosure at the bottom
One unpermitted grading job triggers a four-stage consequence chain — stop-work order, as-built penalty at 2x the base fee, potential insurance denial, and a required resale disclosure at closing.

Five Mistakes That Trigger Permit Disputes in NC

These are the operator-grade failures that cost projects time and money — every one observed across Wake, Mecklenburg, Durham, and Guilford in the past five years.

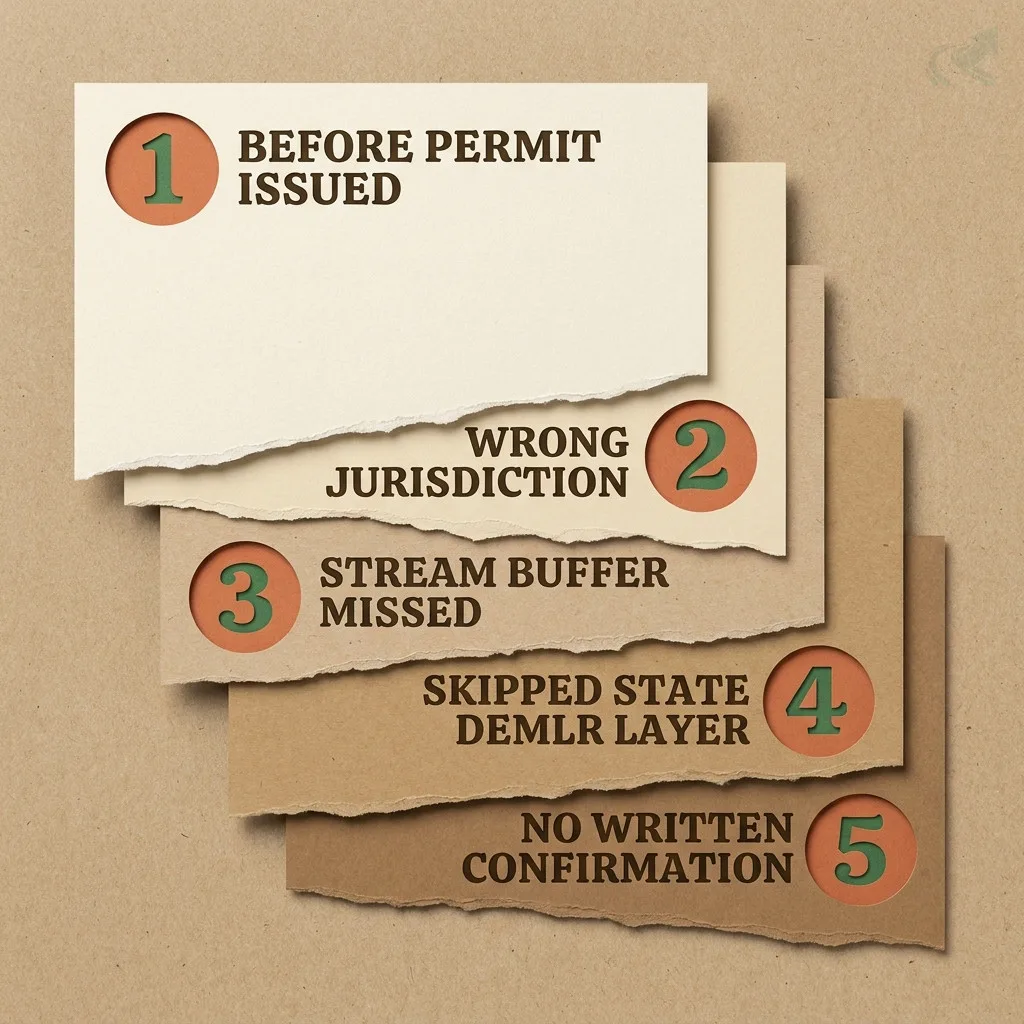

Papercraft layered index cards fanned out on a kraft surface, each card showing one of the five NC permit mistakes: 1 Before Permit Issued, 2 Wrong Jurisdiction, 3 Stream Buffer Missed, 4 Skipped State DEMLR Layer, 5 No Written Confirmation -- terracotta numbered circles on cream and kraft cardstock layers with soft drop shadows
Five operator-grade failures that trigger permit disputes in NC — starting work before issuance, filing in the wrong jurisdiction, missing stream-buffer triggers, skipping the state DEMLR layer, and relying on verbal-only confirmation.
